How To Use The Production Scheduling System

Schedule work orders against your shop's capacity, see when each job will really start and finish, and adjust the plan or the dates when they don't line up.

Updated Nov 9 2026

How To Use The Production Scheduling System

Allow external media cookies to watch this video.

Before you start

  • A work order can be scheduled when it is a build line with a part that has a labor plan (at least one work location with an estimated time), a quantity, and a Ship Date. Stock and charge lines are never scheduled.
  • Each work location needs capacity set up (see Set shop capacity), or the Gantt chart shows Alert! Ordline Status locations don't have capacity defined. No Schedule Data Possible.
  • Planning Gantt Chart needs the Manager or Supervisor role.
  1. Check the order dates

    1. Go to Production > Orders > Production Order List.
    2. Read the Work Start Date and Ship Date columns. The Ship Date (and Dock Date) are your delivery commitment. If you leave Work Start Date blank on the order line, Cetec ERP works it back from the Ship Date using the labor plan time × quantity, assuming unlimited capacity.
    3. Click the Work Start Date column heading and choose Sort A → Z to see the jobs in start order.
  2. Schedule a work order against capacity

    1. Open the work order (click the number in the Order column) and click Schedule (a tab at the top of the Work page, or in the left menu, depending on your company's work order menu). Or, on the Production Order List, hover over the row and click Edit Schedule.
    2. Click Reschedule Forwards to schedule from the Work Start Date, or Reschedule Backwards to schedule back from the Ship Date. Confirm Update Production Schedule Now?. Each work location is booked only up to its capacity; when a day is full, the work moves to the next day with room.
      • Reschedule Forwards starts from the Work Start Date even if it is in the past; with no Work Start Date it starts today.
    3. Compare Scheduled Finish with the Ship Date and Scheduled Start with the Work Start Date. A date that misses is highlighted; hover it for After Order Line Ship Date! or Before Order Line Work Start Date!.
    4. Optional: set Priority Rank (higher numbers schedule first) or tick Schedule Locked? so batch reschedules leave the job alone, then click Update.
  3. See the load on the Gantt chart

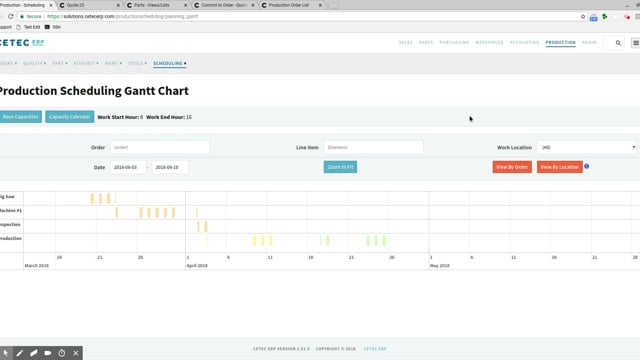

    1. Go to Production > Scheduling > Planning Gantt Chart. The chart starts at today and shows a week.
    2. Switch between View By Order, View By Production Line and View By Location. Hover a bar to see its part, work location and the capacity it uses on that day.
    3. Scroll on the chart to zoom in and out, and drag to move through time, or change the dates at the top (the chart only shows bars between those dates). Type an order number in Order to show just that order's stages.
    4. Click Show Unscheduled Lines to list orders that aren't scheduled yet.
  4. Respond to a conflict

    1. Reschedule the order (Reschedule Forwards / Reschedule Backwards), or drag its bar on the Gantt chart to move it.
    2. Or change the commitment: on the Gantt chart, tick the order's row, click Batch Update Dates and choose Update Work Start Date, Update Ship Date or Update Both. Only change the Ship Date when the customer has agreed to it.
    3. When quantities or capacity change, reschedule again to see the effect on start and finish dates.
